What to do with the house on your lot when a multiplex is still years away

9 min read

The multiplex math works, but not yet. Here is what a suite, a coach house, or a targeted renovation actually does for a property you plan to redevelop later, from the team at RealDream Contracting.

Key takeaway

Spend on a hold-then-redevelop house only when the work survives the redevelopment or the rent repays it before demolition.

By that rule a $60,000 to $120,000 kitchen fails on a short hold, a $100,000 to $160,000 secondary suite conversion needs roughly five years of $2,000 monthly rent just to repay itself, a coach house only pencils if it survives the future multiplex layout, and basic safety work almost always passes. Guest guide from RealDream Contracting, a renovation company in North Vancouver.

What this covers

  • the rule: spending must survive redevelopment or pay for itself in rent first
  • a full secondary suite conversion must repay $100,000 to $160,000 in rent before demolition
  • coach house economics depend on whether it survives the eventual multiplex layout
  • safety and systems work to make the house rentable as is
  • North Vancouver renovation costs run 10 to 15 percent above the Metro Vancouver average
  • decide the redevelopment timeline first, then spend against it
multiplex vancouver north-shore secondary-suite coach-house holding-strategy

Most owners who run the multiplex numbers end up in the same spot. The project makes sense on paper. The start date does not.

Maybe the financing needs another year or two. Maybe a parent still lives in the house. Maybe you want to see where interest rates settle before committing to a build. Whatever the reason, the honest conclusion is that this is a five year plan, not a next spring plan.

Meanwhile the house is still there. It still needs a roof. It still costs money every month. Owners in this position ask me the same question again and again: what should I do with it while I wait? Here is how I think about it after years of renovation work on the North Shore.

TL;DR

  • Spend on the existing house only when the work either survives the redevelopment or repays itself in rent before demolition. If a dollar does neither, keep it.
  • A kitchen renovation runs $60,000 to $120,000 in North Vancouver. On a four year hold, that money is simply gone.
  • A full secondary suite conversion runs $100,000 to $160,000 and takes roughly five years of $2,000 monthly rent just to repay the construction cost. It fails on a short hold and can work on a long one.
  • A coach house only makes sense if it can survive the future multiplex layout. Pay for that siting answer before you pay for design.
  • The cheapest path that almost always passes: electrical, plumbing, roof and heat brought to a safely rentable standard.
  • Decide your redevelopment timeline first, then spend against it. A two year hold and a five year hold justify very different amounts of money.

One rule decides everything

Every dollar you put into that house must do one of two things. Either the work survives the redevelopment, or the rent pays it back before demolition. If a dollar does neither, do not spend it.

A new kitchen fails this test badly. Our published range for an average kitchen renovation in North Vancouver is $60,000 to $120,000, and the on-site work alone takes 8 to 14 weeks. If the house comes down in four years, all of that money is gone. Rent will not return it in that time, and the buyer of a redevelopment lot pays for land, not cabinets. The same logic applies to a bathroom at our published $25,000 to $55,000, and it applies ten times over to a full home renovation, which averages $200,000 to $400,000.

Refinishing worn floors before you rent the house out passes the test easily. It costs little, it makes the place rentable, and the rent covers it long before construction starts.

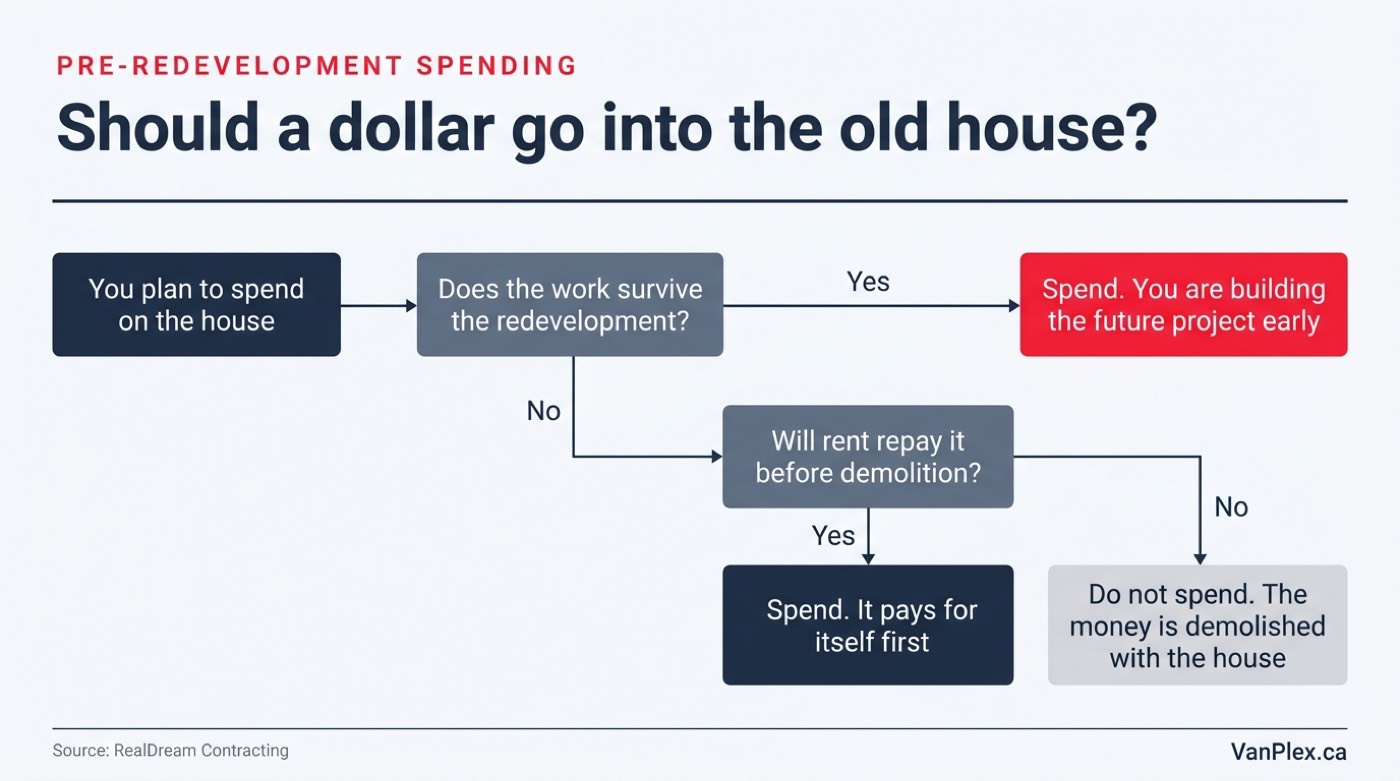

Decision graphic showing the one rule for pre-redevelopment spending: work must survive the redevelopment or repay itself in rent before demolition

That is the whole rule. Survives, or pays for itself first. The rest of this article is that rule applied to the three moves owners usually consider.

Option one: a basement suite

If the house has an unfinished basement, this is the option most people reach for, and it deserves the most careful math, because the real numbers are larger than most owners expect.

From our published cost data, a basic basement finish runs $50,000 to $80,000 for a typical 800 to 1,000 square foot basement and takes 8 to 12 weeks. A recreation room with a bathroom runs $70,000 to $110,000. A full secondary suite conversion runs $100,000 to $160,000 and takes 12 to 18 weeks including the permit process.

Cost chart comparing North Vancouver basement projects: basic finish $50,000 to $80,000, rec room with bathroom $70,000 to $110,000, full secondary suite conversion $100,000 to $160,000

Why does the suite cost so much more than the finish? Because a legal suite is much more than drywall and flooring. It needs a separate entrance, egress windows in the bedrooms with a minimum 3.8 square foot clear opening, a full kitchen, a bathroom, smoke and carbon monoxide detection tied to the main house, fire separation on the ceiling, and sound control between the floors. Each item is there for a reason, and each one costs money.

Now apply the rule. The suite does not survive the redevelopment, so the rent has to repay it before demolition. This is simple division, and it is worth doing before you fall in love with the idea. The table below shows months of full occupancy needed just to return the construction cost, before you count any operating costs or profit.

Conversion costAt $1,800/monthAt $2,000/monthAt $2,400/month
$100,00056 months50 months42 months
$120,00067 months60 months50 months
$160,00089 months80 months67 months

Read that against your timeline. On a two or three year hold, a full suite conversion fails the rule at any realistic rent. On a five year or longer hold with strong rent, it can work, and it carries a second benefit: documented rental income strengthens your file when you eventually ask a lender for construction financing. A property with two years of suite rent on paper reads differently than a property with none.

There is a cheaper middle path. If you rent the whole house to one household, a basic finish at the lower end of the range may be enough to raise the rent, without the cost of making the suite legal and separate.

Two warnings before you commit. First, ceiling height and egress. Houses built before 1980 often lack the headroom for a legal suite without lowering the slab, and slab lowering is genuinely expensive. Have someone measure before you spend on design. Second, water. If the basement has a moisture problem, fixing the foundation or waterproofing adds $15,000 to $40,000 depending on scope, and replacing a failed perimeter drain runs $15,000 to $25,000 because it needs exterior excavation. On the North Shore’s steep lots, drainage is the first thing I check and the thing most owners have never looked at.

Option two: a coach house or laneway home

This one costs more than a suite and behaves differently under the rule, because it might survive.

Depending on the lot and the eventual multiplex layout, a coach house at the rear can sometimes remain standing through the redevelopment. If it survives, the economics change completely. You are building the first unit of the future project early and renting it while you wait. If it comes down with the house, you have built a new structure with a known demolition date, and very little rent can repay a new build in a few years.

So settle one question before spending anything on coach house design: does it survive your multiplex plan? That answer comes from whoever will draw the eventual layout, and it is worth paying for. I have watched owners do this in the wrong order, design the coach house first, then learn it sits exactly where the new building needs to be.

Option three: make it safely rentable and stop

Not every hold needs a project. Often the right answer is the unglamorous list: electrical brought up to standard, plumbing that will not fail on a tenant, a roof that lasts the holding period, heat that works.

If the house went up before 1980, expect some mix of outdated wiring, galvanized plumbing, asbestos containing materials, and framing that no longer matches code. None of it is a crisis. All of it is a cost you want to know about before a tenant moves in, not after.

This option is cheap next to the other two, and nearly all of it passes the rule. Safety and systems work protects you from a much larger bill during the hold, whether the house eventually comes down or not.

The three options side by side

Basement suiteCoach houseSafety work only
Published cost$100,000 to $160,000 for a legal conversionNew construction, priced per projectThe smallest of the three
Survives the redevelopment?NoSometimes. Get the siting answer firstThe spend protects the holding period itself
Repays before demolition?Roughly 5 years at $2,000/month rentOnly if it survivesYes, through avoided failures and a rentable house
Best fitHolds of 5+ years with suite-ready height and egressLots where the rear unit fits the future layoutEvery hold, and short holds especially

What renovation money actually buys here

A few numbers from our published cost data that help with planning, whichever option you pick.

Labour and trades take 35 to 45 percent of a renovation budget. Materials and fixtures take another 25 to 35 percent, design and permits 8 to 12 percent, and project management 10 to 15 percent, with a 5 to 10 percent contingency on top. Building permits for a renovation typically run $1,500 to $5,000.

On rates: journeyman electricians, plumbers and carpenters command $45 to $85 an hour, and during peak season the best trades are booked 4 to 8 weeks out. That last number surprises people. If your plan depends on finishing a suite before a specific tenancy date, put the booking lead time into the schedule at the start, then add the 12 to 18 week conversion timeline on top of it.

And in North Vancouver specifically, renovation costs tend to run 10 to 15 percent higher than the Metro Vancouver average. Hillside access, older housing stock that needs more structural work, and steady trade demand all push costs the same way. Keep that premium in mind when you compare quotes from across the region.

Decide the timeline first

Whether to hold and improve, or simply hold, depends on how much you trust your redevelopment date. That is a financing and family question, not a construction question, and you can answer it better than any contractor.

The owners who do best decide the timeline first and then spend against it. A five year hold and a two year hold justify very different amounts of money. Get the timeline honest, and the spending decisions mostly make themselves. And if you have not yet confirmed what your lot supports, run the property through VanPlex before you spend anything, because the redevelopment plan is the thing every one of these decisions hangs on.

Frequently asked

Will a renovation raise what a developer pays for my lot?

No. The buyer of a redevelopment lot is paying for the land and what can be built on it. Money spent on finishes inside a house with a demolition date does not come back in the land price. That is exactly why the survive-or-repay rule exists.

How long does a secondary suite conversion take?

From our published data, 12 to 18 weeks including the permit process, on top of the 4 to 8 weeks it can take to book good trades in peak season. Plan backwards from the date you want a tenant in place.

Is an illegal suite a shortcut worth taking?

I will not build one, and I would not advise it. The legal requirements, a separate entrance, proper egress windows, fire separation, interconnected smoke and carbon monoxide detection, exist for tenant safety, and the rent from a legal suite is the rent a lender will actually count when you go for construction financing later.

What should I fix before renting out an older house as is?

Electrical, plumbing, roof and heat, in that spirit if not that order. On pre-1980 houses I also check drainage early, because on steep North Shore lots a failed perimeter drain is a $15,000 to $25,000 problem that gets worse the longer it waits.

This guide was written by the team at RealDream Contracting, a renovation company serving North Vancouver and West Vancouver, working mostly in the area’s 1960s to 1980s housing stock, from the first site visit to the final deficiency sign-off. Reach them at [email protected].

Frequently asked questions

Should I renovate my house if I plan to redevelop it into a multiplex later?

Only if the work either survives the redevelopment or repays itself in rent before demolition. A kitchen renovation in North Vancouver runs $60,000 to $120,000, and if the house comes down in four years, that money is gone because a buyer of a redevelopment lot pays for the land, not the cabinets. Refinishing worn floors before renting the house out passes the test easily because it costs little and the rent covers it quickly.

Is a secondary suite conversion worth it before a multiplex redevelopment?

It depends on the hold length. A full secondary suite conversion runs $100,000 to $160,000 and takes roughly five years of $2,000 monthly rent just to repay the construction cost, so it fails the rule on a two or three year hold and can work on a five year or longer hold. Documented rental income also strengthens a lender file when the owner later applies for construction financing.

What does a legal secondary suite need that a basic basement finish does not?

A legal suite needs a separate entrance, egress windows in the bedrooms with a minimum 3.8 square foot clear opening, a full kitchen, a bathroom, smoke and carbon monoxide detection tied to the main house, fire separation on the ceiling, and sound control between floors. Each requirement adds cost, which is why a full secondary suite conversion at $100,000 to $160,000 costs far more than a basic basement finish at $50,000 to $80,000.

Is a coach house or laneway home a good investment before a multiplex build?

It depends on whether the coach house can remain standing through the eventual multiplex layout. If it survives the redevelopment, the owner is effectively building the first unit of the future project early and renting it while waiting. If it comes down with the house, the owner has built a new structure with a known demolition date, and rent cannot repay a new build in only a few years, so the siting answer should come from whoever will draw the eventual multiplex layout before any coach house design work begins.

What is the cheapest way to prepare an older house for renting before redevelopment?

Bring the electrical, plumbing, roof and heat up to a safely rentable standard and stop there. Houses built before 1980 often mix outdated wiring, galvanized plumbing, asbestos containing materials, and framing that no longer matches code, and none of it is a crisis if it is addressed before a tenant moves in. This option is the smallest of the three renovation paths and nearly all of it passes the survive-or-repay test, because it protects the holding period itself.

How long does a secondary suite conversion take from start to finish?

A full secondary suite conversion takes 12 to 18 weeks including the permit process. On top of that, journeyman electricians, plumbers and carpenters are booked 4 to 8 weeks out during peak season, so an owner planning to finish a suite before a specific tenancy date should add that booking lead time to the schedule before counting the 12 to 18 week build itself.

What should I check before renting out an older North Vancouver house as is?

Check electrical, plumbing, roof and heat first, since those are the systems most likely to fail on a tenant. On pre-1980 houses, drainage deserves an early check too, because on steep North Shore lots a failed perimeter drain runs $15,000 to $25,000 to replace due to the exterior excavation it needs, and foundation waterproofing for a moisture problem adds $15,000 to $40,000 depending on scope.

Does renting out the house increase what a developer will pay for the lot later?

No. A buyer of a redevelopment lot pays for the land and what can be built on it, not for finishes inside a house that has a demolition date. Money spent on a kitchen, a bathroom, or a full home renovation does not come back in the land price, which is the reason the survive-or-repay rule exists: only work that survives the redevelopment or repays itself in rent before demolition is worth the spend.

Free 12-page guide for Vancouver-area homeowners. Build, sell, hold, or partner — side-by-side comparison of the numbers, timeline, and risk on each path.

Verified phone required. We'll text you the link in 60 seconds.

RealDream Contracting

RealDream Contracting

North Shore Renovation Company (realdream.ca)

RealDream Contracting is a renovation company serving North Vancouver and West Vancouver. Most of its work is in the area's 1960s to 1980s housing stock, where old electrical panels, galvanized plumbing, drainage on steep lots, and pre-seismic foundations are the usual finds.

Want insights like this delivered weekly?

Join 2,500+ property owners getting ROI case studies, market data, and exclusive opportunities.

No spam. Unsubscribe anytime.

A newly completed ground-oriented Vancouver multiplex on a residential street, the kind of project whose value is often lost to a weak go-to-market plan
8 min read

5 Mistakes Multiplex Builders Make in This Market

Most Vancouver multiplex builders leave money on the table, not because the buildings are bad, but because the go-to-market plan is broken. Michael Lee, Partner at MultiLiving (BC's dedicated marketplace for multiplex homes), breaks down the five costliest mistakes, from waiting until listing day to market to competing on price with no brand, and the fix for each.

Strategy
multiplexvancouver+7
By Michael Lee • Partner, MultiLiving (multiliving.ca)
Vancouver west-coast multiplex on a 33 foot residential lot beside an empty for-sale sign on a similar neighbouring lot representing the decision a BC homeowner faces between co-developing their property as a Bill 44 multiplex or simply selling at land value
Featured
8 min read

Co-Develop Your Property or Just Sell? An Honest Take

Bill 44 unlocked 3-6 units on most BC lots, and homeowners keep asking if they should build or sell. After looking at thousands of properties across Vancouver, Burnaby, and Kelowna, here's what actually separates the lots that should be developed from the ones where a clean sale is the smarter call.

Strategy
co-developmentmultiplex+9
By David Babakaiff • Co-Founder, VanPlex | 25+ Years BC Construction
Vancouver City Hall seen past a residential street of new multiplex buildings, the setting for the October 17, 2026 mayoral election
9 min read

Vancouver Mayor 2026: Every Candidate Ranked on Multiplexes

Eight candidates are running for Vancouver mayor on October 17, 2026. The voche.me editorial team read every platform and ranked them on one question: who makes it easier to build a multiplex? Pete Fry has the most detailed plan, Ken Sim has the strongest record, and Colleen Hardwick would ask the Province to revisit Bill 44.

Policy Analysis
vancouver-election-2026mayor+9
By Voche.me editorial • Vancouver election guide (voche.me)
